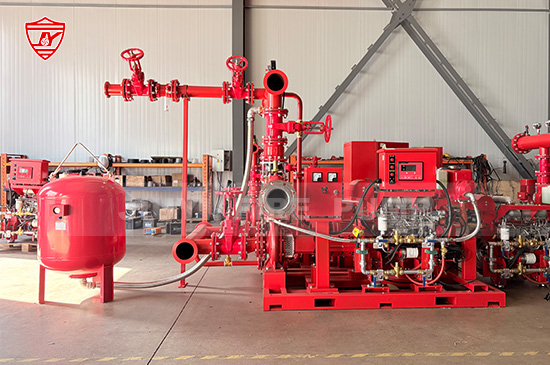

Commissioning a containerized fire pump system is a critical step in ensuring that fire protection equipment operates reliably when it is needed most. A properly commissioned system should not only start and stop correctly, but also deliver the required water flow and pressure under the project’s specified operating conditions.
Unlike conventional fire pump installations, a containerized fire pump system integrates major fire protection equipment inside a purpose-built enclosure. Depending on the project, the container may include an electric fire pump, diesel fire pump, jockey pump, fire pump controllers, piping, valves, fuel system, ventilation, exhaust system, batteries, lighting, and other auxiliary equipment. This integrated design can simplify installation at the project site, but it also requires a systematic commissioning process.
This guide explains the major steps involved in commissioning a containerized fire pump system and highlights the checks that fire protection contractors, engineers, and facility owners should consider before placing the system into service.
.jpg)
Before starting commissioning, review the approved fire protection design and the equipment documentation.
The commissioning team should verify the required pump capacity, rated pressure, power supply, voltage, frequency, pump arrangement, control philosophy, and operating sequence. The actual equipment installed inside the container should match the approved specifications.
Important documents may include:
Approved fire protection drawings
Pump performance curve
Equipment data sheets
Fire pump controller documentation
Electrical drawings
Piping and instrumentation diagrams
Installation instructions
Factory test records
Pressure and flow test requirements
Applicable project specifications
Applicable local fire protection requirements
The commissioning team should also confirm whether the project requires electric and diesel fire pumps, a jockey pump, or another configuration.
Any discrepancy between the approved design and the installed equipment should be resolved before functional testing begins.

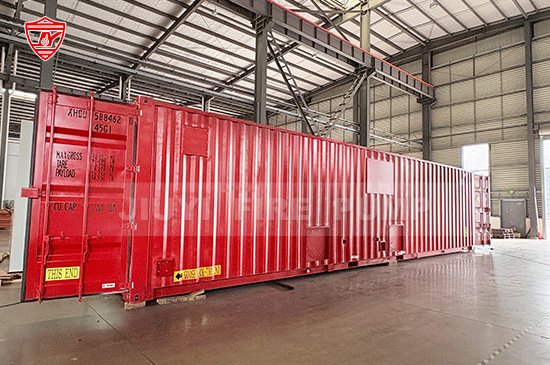

The first physical commissioning step is a detailed inspection of the containerized fire pump enclosure.
Check the structural condition of the container and confirm that doors, access panels, ventilation openings, lighting, drainage, and other components are correctly installed.
The equipment should be securely mounted and accessible for operation and maintenance.
Particular attention should be given to the relationship between the fire pumps and surrounding equipment. There should be sufficient clearance for inspection, maintenance, valve operation, controller access, and emergency intervention.
The commissioning team should inspect:
Electric fire pump
Diesel fire pump
Jockey pump
Fire pump controllers
Suction and discharge piping
Isolation valves
Check valves
Pressure gauges
Flow measurement equipment
Fuel tank and fuel piping
Batteries and battery chargers
Ventilation equipment
Exhaust system
Heating or cooling equipment where required
Lighting and electrical connections
Drainage arrangements
Emergency access
The container should also be installed on a suitable foundation capable of supporting the complete operating weight of the system.
Correct piping installation is essential for fire pump performance.
Before starting the pumps, verify that suction and discharge piping has been installed according to the approved design. Pipe supports should be secure, connections should be properly tightened, and the system should be free from construction debris.
Suction piping deserves particular attention because poor suction conditions can reduce pump performance and contribute to cavitation.
Check the suction line for correct pipe size, alignment, valves, strainers where applicable, and connection quality. Confirm that suction valves are fully open before the pump is placed into automatic service.
On the discharge side, verify the correct installation and orientation of check valves, isolation valves, pressure gauges, test connections, and other components.
The system should be hydrostatically tested where required by the project specifications and applicable standards before final pump performance testing.
For an electric fire pump, the incoming power supply must be checked before the pump is started.
Verify the voltage, frequency, phase configuration, cable size, grounding, disconnect arrangements, and electrical connections against the approved design.
The fire pump controller should receive the correct power supply and should indicate normal operating conditions.
The commissioning team should also check:
Incoming voltage
Phase sequence
Grounding
Cable termination
Circuit protection
Controller connections
Motor connections
Alarm circuits
Remote monitoring connections
Emergency power arrangements, where applicable
The electric motor should be checked for correct rotation before the pump is operated under full load.
When the containerized fire pump system includes a diesel fire pump, additional commissioning checks are required.
Confirm that the diesel engine has the correct lubricating oil, coolant, and fuel. Check the fuel tank level and inspect fuel lines and connections for leakage.
The batteries should be fully charged, correctly connected, and suitable for engine starting. Battery chargers should be operating correctly.
The engine cooling system, exhaust system, ventilation system, and fuel system must also be inspected.
Important checks include:
Engine oil level
Coolant level
Fuel level
Battery condition
Battery charger operation
Fuel piping
Exhaust connections
Engine ventilation
Engine temperature
Engine alarms
Emergency shutdown arrangements
The diesel engine should start reliably from the fire pump controller under automatic starting conditions.
The jockey pump maintains system pressure during normal conditions and helps prevent unnecessary starting of the main fire pump.
Before commissioning, verify the jockey pump’s suction and discharge connections, electrical supply, pressure settings, isolation valves, and controller configuration.
The pressure settings should be coordinated with the main fire pump starting sequence.
A controlled pressure drop can then be introduced into the system to verify that the jockey pump starts and stops at the intended pressure levels.
The main fire pump should not start unnecessarily when the jockey pump is capable of restoring normal system pressure.
The fire pump controller is a key part of the complete system.
Before functional testing, review the controller settings against the approved project requirements. This includes automatic start pressure, manual start functions, alarm settings, monitoring signals, and other relevant parameters.
For systems with both electric and diesel fire pumps, the starting sequence should be verified carefully.
The commissioning team should confirm that the controller can correctly detect a pressure drop and initiate the required pump starting sequence.
All visible indicators, alarms, and status signals should also be checked.
Where the system is connected to a building management system, fire alarm system, or remote monitoring platform, the communication signals should be tested as part of commissioning.
Before relying on automatic operation, each pump should be tested manually according to the approved commissioning procedure.
Start the electric fire pump and verify that the motor and pump operate smoothly. Observe pressure, vibration, noise, and other operating conditions.
For the diesel fire pump, verify manual engine starting and monitor engine operating parameters.
During manual testing, check for unusual vibration, abnormal noise, excessive temperature, leakage, unstable pressure, or other indications of incorrect installation or operation.
Any abnormal condition should be investigated before continuing with the commissioning process.
Automatic starting is one of the most important parts of fire pump commissioning.
The system should be placed in the appropriate automatic operating mode and the required pressure-drop condition should be simulated safely.
The commissioning team should verify that the correct pump starts at the specified pressure.
For a system containing electric and diesel fire pumps, the starting sequence should be tested according to the approved design. The objective is to confirm that the pumps respond correctly when system pressure decreases.
Automatic operation should also be checked after temporary manual interventions to ensure that the system returns to its normal automatic condition.
A fire pump should not be evaluated only by whether it starts. The most important commissioning verification is whether it can deliver the required flow and pressure.
A performance test should be conducted using suitable calibrated test equipment and according to the project requirements and applicable fire protection standards.
Typical test points may include:
Churn or no-flow condition
Rated flow
A higher flow condition where required
At each test point, record the pump discharge pressure and flow rate.
For a diesel fire pump, engine speed and relevant operating parameters should also be monitored.
The measured results should be compared with the approved pump performance curve and project requirements.
A pump that starts successfully but cannot provide the required hydraulic performance should not be considered fully commissioned.
During the performance test, the commissioning team should observe the entire system rather than only the pump.
Check piping, valves, connections, supports, gauges, drains, and other components for leakage or abnormal behavior.
The container itself should also be monitored during operation.
For diesel systems, verify that ventilation and exhaust systems are functioning properly under operating conditions. Adequate ventilation is particularly important because the engine generates heat and exhaust gases during operation.
For systems installed in areas with low temperatures, verify that the container’s environmental protection and heating arrangements can maintain suitable operating conditions.
A containerized fire pump system contains multiple safety and monitoring functions that should be verified during commissioning.
Depending on the system configuration, these may include:
Low fuel alarm
Engine fault alarm
Battery failure alarm
Charger failure alarm
High engine temperature alarm
Low oil pressure alarm
Pump running indication
Controller fault indication
Power failure indication
Emergency shutdown functions
Remote alarm signals
Each applicable alarm should be tested individually and the result recorded.
The purpose is to ensure that operators can identify important system conditions quickly and take appropriate action.
Containerized fire pump systems require special attention to environmental control because major equipment is installed inside an enclosed space.
A diesel engine requires adequate combustion air and ventilation. At the same time, engine exhaust gases must be safely discharged outside the container.
During commissioning, verify that ventilation fans, louvers, exhaust pipes, and related components operate correctly.
The commissioning team should also check for excessive heat accumulation inside the enclosure.
For installations exposed to cold climates, heating and freeze protection should be verified. For hot climates, ventilation and cooling capacity become especially important.
The environmental conditions inside the container should remain suitable for reliable operation of the pumps, engines, controllers, batteries, and other equipment.
The commissioning process should include realistic operating scenarios.
Examples may include loss of normal power for an electric pump, pressure loss in the fire protection system, diesel engine starting, controller alarm conditions, and restoration of normal operating conditions.
The purpose is to verify that the fire pump system responds according to the approved sequence.
After each test, the system should be returned to its normal automatic operating condition.
This final reset is important because a fire pump that has been left in manual mode or with an isolation valve closed is not ready for emergency service.
All important commissioning results should be documented.
The final commissioning record should include equipment identification, pump model, motor or engine information, test conditions, flow rates, pressures, starting pressures, alarm results, and any observations.
Performance test results should be recorded clearly so that they can be compared with the approved pump curve and retained as part of the project documentation.
Photographs, calibration records, inspection records, and corrective-action records may also be included where required.
Good documentation provides the facility owner with a useful reference for future inspections, maintenance, troubleshooting, and performance verification.
After all commissioning tests have been completed, the system should be inspected one final time.
Confirm that all valves are in their correct normal positions, controllers are in automatic mode, fuel tanks are adequately filled, batteries are connected, alarms have been reset, and the fire pump system is ready for service.
The commissioning team should also provide operating and maintenance documentation to the facility owner or responsible operator.
Operators should understand the basic operation of the electric pump, diesel pump, jockey pump, controller, alarms, valves, and emergency procedures.
Training is particularly important for containerized systems because the equipment is integrated into a relatively compact enclosure and may contain several interconnected systems.
A containerized fire pump system can simplify installation and provide a compact, factory-integrated solution for projects where conventional pump rooms are difficult or impractical.
However, factory integration does not eliminate the need for site commissioning.
Transportation, installation, site connections, environmental conditions, power supply, fuel systems, piping, and other project-specific factors can affect final system performance.
Proper commissioning verifies that the complete installed system performs as intended.
For fire protection projects, commissioning should therefore be treated as a complete system verification process rather than simply starting the pump for the first time.
.jpg)
Commissioning a containerized fire pump system requires a systematic approach covering mechanical installation, electrical connections, hydraulic performance, pump controls, diesel engine operation, ventilation, alarms, safety functions, and final documentation.
The most important objective is to verify that the complete system can provide the required fire-fighting water flow and pressure reliably when an emergency occurs.
As a fire pump manufacturer, we recommend involving qualified commissioning personnel and following the approved project specifications, equipment instructions, applicable fire protection standards, and local authority requirements throughout the process.
A properly designed, manufactured, tested, installed, and commissioned containerized fire pump system provides an integrated solution for demanding fire protection applications while helping project owners simplify installation and equipment management.
